Bethlehem Steel Corporation Yard, San Pedro, California



E.M. Young -  Christened/Launched the ship 12 Sept-43









CY Hull #: 9016

CY Keel Laid: 3-18-43

CY Launched: 9-12-43

CY Commissioned: 12-31-43

CY Time to Build: 288days - 9 ½ Months to Build  (700dayPrewar)









Cassin Young Sisters Built in San Pedro:

Hull #

Name

DD-#

Delivery

Disposition

9001

Boyd

544

8-May-43

To Turkey as Iskenderun (D 343) 1969, struck 1981

9002

Bradford

545

12-Jun-43

To Greece as Thyella (D 28) 1962, struck 1981

9003

Brown

546

10-Jul-43

To Greece as Navarinon (D 63) 1962, struck 1981

9004

Cowell

547

23-Aug-43

To Argentina as Almirante Storni (D 24) 1971, struck 1982

9013

Hopewell

681

30-Sep-43

Sunk as target 1972

9014

Porterfield

682

30-Oct-43

Target hulk 1976

9015

Callaghan

792

27-Nov-43

Sunk by Japanese aircraft off Okinawa 1945

9016

Cassin Young

793

31-Dec-43

Memorial in Charlestown MA 1981

9017

Irwin

794

14-Feb-44

To Brazil as Santa Caterina (D 32) 1968, struck 1978

9018

Preston

795

20-Mar-44

To Turkey as Icel (D 344) 1969, struck 1981







City: San Pedro, CA

Ship Yard: Bethlehem Steel

Fastest Ship Built: USS Norris in 253 days



Yard History:

Bethlehem Steel’s San Pedro shipyard at Terminal Island was located within the Ports of San Pedro (Los Angeles Harbor) and Long Beach in San Pedro Bay, California, near the permanent home of the Queen Mary.



Here at Berth 240, Southwest Shipbuilding was founded in 1917, leased by Bethlehem in 1921 and purchased in 1925. A ship repair facility for most of its existence, it was one of several yards provided with Maritime Administration funds to build ships for World War II.



Beginning in 1940, the yard built 26 destroyers:

  • Four Benson-class warships
  • Ten Fletcher-class warships
  • Eight Allen G. Sumner-class destroyers
  • Four Gearings-class vessels



Three of San Pedro’s four Bensons took more than a year to launch. The Fletchers, Sumners and Gearings all took much less. Minimum time to commissioning was set with the last ship completed before VJ day, Norris at 253 days.



After the war, shipbuilding was discontinued but repair and other facilities were maintained.



In 1981, Bethlehem Steel sold the yard to Southwest Marine, Inc. which continues to operate it today.

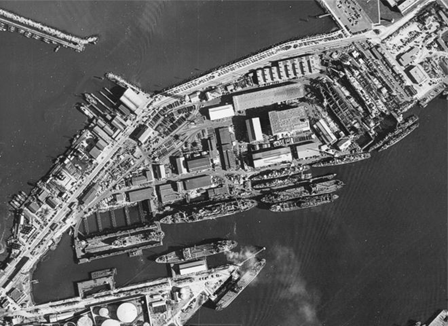

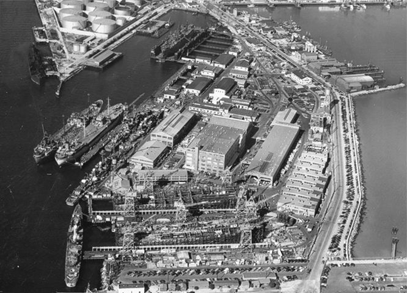

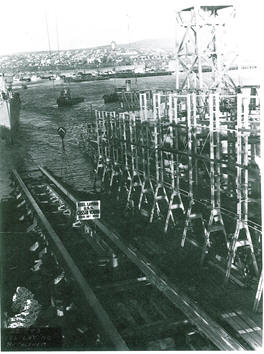

San Pedro Yard Circa: 1945
